World Class Textile Producer with Impeccable Quality

Garment Production Lead Time: What Apparel Brands Should Plan For

Garment Production Lead Time: What Apparel Brands Should Plan For
  • Aug 05, 2026
  • Sourcing & Supplier Guide
Tags
  • Apparel Manufacturing
  • Bulk Production
  • Garment Production
  • OEM Clothing
  • Production Lead Time
Table of Contents

Key Sourcing Takeaways

  • Bulk production lead time should be measured from a defined approval gate to a defined factory-release point, not from the first inquiry to warehouse delivery.
  • Runtang counts the bulk lead time from Pre-Production Sample approval; the PO, deposit, materials, colorways, size quantities, labels, packaging, and production slot should also be ready for execution.
  • BBasic styles using in-stock fabric may take 3–15 working days, while custom-dyed or complex orders may require 1–3 months; unchanged repeat orders are reviewed case by case.
  • A change to color, construction, artwork, labels, or quantity after PP approval can reset affected approvals and requires a revised production schedule.

Apparel brands should not ask only how many weeks garment production takes. They should first define when the factory starts counting, what must be approved before that point, and whether the quoted end date means bulk completion, inspection release, or warehouse arrival. For Runtang orders, bulk production lead time begins after the Pre-Production Sample is approved and ends when the finished goods leave the factory. International freight, customs clearance, and destination warehousing are separate planning periods. This boundary gives buyers a usable production calendar and makes delays easier to assign to a specific approval, material, manufacturing, inspection, or logistics stage.

What Garment Production Lead Time Actually Covers

Garment production lead time is the factory-controlled period between the approved Pre-Production Sample and the goods leaving the factory, provided the order is otherwise ready to execute. A Pre-Production Sample, usually shortened to PP sample, is the final garment reference used before bulk manufacturing. It should reflect the approved fabric, color, measurements, construction, trims, decoration, labels, and other details that the production team must follow.

The PP gate does not erase the other commercial requirements. The final PO, deposit, materials, colorways, size breakdown, label artwork, packaging instructions, and production slot should be confirmed by or before PP approval. If one of these items remains open, the factory may need to reconfirm the promised ex-factory window even though the physical sample has been approved.

Planning periodStartEndManage it as
Product developmentInitial design or tech pack submissionPP sample approvalA separate development timeline
Bulk garment productionPP sample approval, with executable order conditions confirmedGoods leave the factoryThe factory production lead time
LogisticsFactory dispatch or carrier pickupDelivery to the brand's warehouseA separate freight and import timeline
Brands should therefore record at least three dates: PP approval, ex-factory dispatch, and required warehouse arrival. Combining them into one delivery estimate hides which party owns each risk.

Build the Production Calendar Around Approval Gates

A reliable production calendar is built around written approvals rather than informal progress updates. The following sequence keeps the product standard, materials, and delivery window aligned.

  • Freeze the order scope. Confirm the style, quantities, colors, size breakdown, price, Incoterm, and target market before the PP sample is signed off. An incomplete scope prevents the factory from treating the schedule as final.
  • Approve materials and colorways. Confirm the fabric, trims, lab dips, print colors, embroidery files, and any wash effect needed for the final reference. A screen image is not a reliable substitute for an approved physical color standard when dyeing is involved.
  • Approve the PP sample in writing. Use the PP garment as the production reference and record any accepted deviations. The broader garment sampling process should close fit, measurement, construction, and decoration questions before the bulk clock starts.
  • Release labels and packaging. Confirm main labels, care labels, hangtags, polybags, carton marks, and packing ratios early enough for production. For products intended for the United States, the Federal Trade Commission's textile labeling guidance explains that most covered textile products must identify fiber content, country of origin, and the manufacturer or another business responsible for marketing or handling the item; these details should not be left until finished garments are waiting to be packed.
  • Confirm the production slot and control points. Material preparation, cutting, sewing, decoration, finishing, and inline checks must be coordinated against the approved reference. Runtang's in-house knitting, dyeing, and garment production capabilities can reduce cross-supplier handoffs, but they do not remove the need for clear approvals.
  • Reserve inspection and release time. Bulk completion is not the same as shipment release. The calendar should allow for final checks, corrective work if required, packing verification, and the buyer's agreed pre-shipment clothing quality inspection.

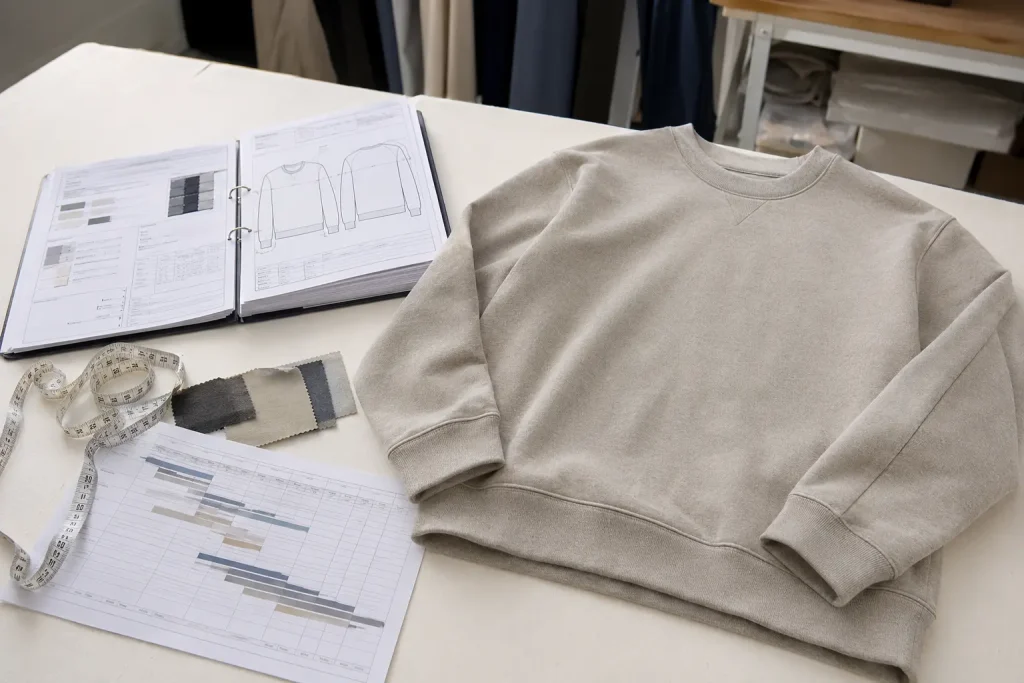

Grey crewneck sweatshirt displayed with a tech pack, fabric swatches, measuring tape, and production schedule.
Bulk scheduling should begin only after the production reference is formally approved.

Buyer Actions That Commonly Extend the Timeline

The most common buyer-controlled delays are incomplete technical information and repeated confirmation of the design. These issues have the greatest impact when they remain unresolved after materials or production capacity have already been reserved.

Buyer actionDownstream effectBetter control
Tech pack contains TBD itemsMaterials, operations, costing, or measurements cannot be lockedClose construction and specification gaps before PP approval
Design drawing requires repeated confirmationPattern, artwork, decoration placement, or sample approval may need another roundConsolidate comments into one version-controlled response
Color or fabric changes after PP approvalLab dips, sourcing, testing, and the production reference may need to restartTreat the change as a new scheduling event
Label or packaging files arrive lateFinished garments may wait for packing materialsApprove artwork and packing ratios alongside the PP sample
Size quantities change lateCutting markers, bundle plans, labels, and carton ratios may be affectedFreeze the size breakdown before bulk cutting
Launch date is treated as the factory dateFreight, customs, and warehouse intake are omittedTrack ex-factory and in-hand dates separately
A correction made before materials and the production slot are committed is usually easier to absorb; the same correction after PP approval can reset several linked tasks and should trigger a written schedule review.

Product Decisions That Change Production Scheduling

Production complexity comes from the number of approvals and operations, not simply from the garment category. A basic style made from available fabric has fewer variables than a style requiring custom dyeing, several decorations, garment washing, or coordinated set packaging.

  • A custom hoodie production schedule may expand when the order includes heavy knitted fabric, custom dyeing, multi-position embroidery, printing, or wash effects. Each added process needs an approved reference and a place in the production sequence.
  • A custom sweatshirt set adds coordination between top and bottom pieces. Fabric lots, color matching, size ratios, decoration placement, and set packing must remain synchronized.
  • A pajama set order can require paired sizes, multiple labels, packing ratios, and retail-ready boxes or bags. Delays in one component can hold the complete set even if sewing is finished.

Runtang's directional ranges are 3–15 working days for basic styles using in-stock fabric and 1–3 months for custom-dyed or complex orders. An unchanged repeat order is quoted case by case because fabric availability, capacity, quantity, and the required ex-factory window can differ from the previous run.

Work Backward From the Required In-Hand Date

Brands should plan from the date stock must be available at their warehouse, then separate each earlier milestone. This avoids using a marketing launch date as if it were a factory shipment date.

  1. Set the required in-hand date. Use the date the warehouse must receive saleable stock, not the campaign announcement date.
  2. Subtract logistics time. Plan international transport, customs clearance, local delivery, and warehouse receiving outside the factory production window.
  3. Reserve inspection and corrective time. Allow space between bulk completion and dispatch for agreed checks and any necessary rework.
  4. Confirm the ex-factory window. Obtain a written dispatch range based on the approved order scope and available production slot.
  5. Calculate the latest PP approval date. Work backward using the factory's confirmed bulk lead time for that specific order.
  6. Add buyer-side decision time. Include internal review, consolidated feedback, artwork release, payment steps, public holidays, and any approval buffer.

Marketing should not lock a launch date until the brand has an approved PP sample and a confirmed ex-factory window. A provisional launch can be used earlier, but it should remain adjustable until those two controls are in place.

Worker checking folded navy sweatshirts beside shipping cartons before the order leaves the garment factory.
Inspection and corrective action need calendar space before the ex-factory date.

Estimate Garment Production Timing Before the PO, Then Confirm the Bulk Schedule

Before the PO, the factory can provide only a provisional timing estimate. To assess whether the required in-hand date is feasible, provide the tech pack, target fabric, color count, total quantity, size breakdown, decoration files, label and packaging requirements, target market, and required warehouse-arrival date.

The confirmed bulk schedule comes after written PP approval. Runtang counts the bulk lead time from that approval date; the PO, deposit, materials, colorways, size quantities, labels, packaging, and production slot should already be ready for execution. If any prerequisite remains open, the ex-factory window should be reconfirmed.

For an OEM clothing production project, this two-stage approach is more useful than a single promise such as “delivery in four weeks.” The pre-PO figure remains an estimate, while the post-approval schedule is tied to defined inputs, inspection timing, and an ex-factory dispatch range. The written schedule should identify the PP approval date, bulk start condition, inspection window, ex-factory range, and what types of post-approval changes require re-quotation or rescheduling.

Frequently Asked Questions

When does bulk garment production lead time start?

Runtang counts bulk garment production lead time from written approval of the PP sample. The PO, deposit, materials, colorways, size quantities, labels, packaging, and production slot should also be ready for execution; an unresolved prerequisite can require the ex-factory window to be reconfirmed.

Does PP sample approval mean sewing starts immediately?

Not necessarily. PP approval closes the product reference, but cutting or sewing may start according to the confirmed production slot and material readiness. The written calendar should distinguish the lead-time start date from the physical line-start date.

Do additional colors extend garment production lead time?

Additional colors can extend the timeline when each shade requires a separate lab dip, custom dye lot, matching trim, print approval, or PP reference. Existing approved materials may reduce the added work, but new color development should be scheduled as its own approval path.

Is shipping included in the factory's quoted lead time?

No, not when the endpoint is ex-factory dispatch. International freight, customs clearance, local delivery, and warehouse receiving should be planned separately and added after the factory release date.
